Revision History
Rev. |
Description of Modification |
Date |
1.0 |
1st Submission |
20/03/2024 |
2.0 |
2nd Submission |
25/03/2024 |
3.0 |
3rd Submission |
26/03/2024 |
TABLE OF CONTENTS
4. Summary of Exceedance, Complants, Notification of Summons and Prosecutions
7. Conclusion and Recommendations
Appendix A Master Programme
Appendix B Overview of Mainlaying in Tseung Kwan O
Appendix C Summary of Implementation Status of Environmental Mitigation (EMIS)
Appendix D Summary of Exceedance
Appendix E Complaint Log
Appendix F Event/ Action Plan for Noise and Landfill Gas
Appendix G Waste Flow Table
A1. Penta-Ocean - Concentric Joint Venture (POCJV) is contracted to carry out the Mainlaying in Tseung Kwan O under Contract No. 13/WSD/16 (hereinafter known as “the Project”).
A2. In accordance with the Environmental Monitoring and Audit (EM&A) Manual for the Project, EM&A works should be carried out by Environmental Team (ET), Acuity Sustainability Consulting Limited (ASCL), during the construction phase of the Project.
A3. The construction works of Mainlaying in Tseung Kwan O were commenced on 30 August 2018. This is the 22nd quarterly Environmental Monitoring and Audit (EM&A) summary Report prepared by ASCL. This report presents the EM&A works carried out during the period of 1 November to 31 January 2024.
A4. All the environmental monitoring works were conducted in accordance with the EM&A Manual. The monitoring results were checked and reviewed. Site audits were conducted once per week. The implementation of the environmental mitigation measures, Event Action Plans and environmental complaint handing procedures were also checked.
A5. A summary of the monitoring activities undertaken in this reporting period is listed below:
Monitoring Activities |
Frequency |
Daytime Noise monitoring |
15 times |
Landfill Gas Monitoring |
309 times |
Environmental Site Inspection |
13 times |
A6. All construction noise monitoring was conducted as scheduled in the reporting quarter. No Action or Limit Level exceedance for construction noise monitoring was recorded in the reporting quarter.
A7. No Action or Limit Level exceedance of landfill gas monitoring was recorded in the reporting quarter.
A8. One (1) environmental complaint was received in the reporting quarter. No notification of summons and prosecution was received in the reporting quarter. The Complaint Log is presented in Appendix E.
A9. There were no changes to be reported that may affect the on-going EM&A programme.
1.1. Background
1.1.1. The proposed Desalination Plant at Tseung Kwan O (DPTKO) will produce potable water with an initial capacity of 135 million litres per day (MLD), expandable to an ultimate capacity of 270 MLD in the future to provide a secure and alternative freshwater resource complying with the World Health Organization (WHO) standards. The plant will adopt the Seawater Reverse Osmosis (SWRO) technology, which dominates the market due to its reliability and progressive reduction in cost as the technology advances.
1.1.2. Pursuant to the Environmental Impact Assessment Ordinance (EIAO), the Director of Environmental Protection granted the Variation of Environmental Permit (No. EP-503/2015/A) to Water Supplies Department (WSD) for the Project on 26 January 2018.
1.1.3. The scope of the Contract may be considered in brief, to consist of the laying of about 10km long 1200mm diameter freshwater mains and the associated works along the alignment of the Project as shown with the overall view in Appendix B.
1.2. The Reporting Scope
1.2.1. This is the 22nd Quarterly EM&A Report for the Project which summarizes the key findings of the EM&A programme during the reporting period from 1 November 2023 to 31 January 2024.
1.2.2. Contact details of the key personnel are presented in Table 1.1 below:
Table 1.1 Contract Details of Key Personnel
Party |
Position |
Name |
Telephone no. |
Penta-Ocean-Concentric Joint Venture |
Environmental Officer |
Calvin Chik |
9863-5630 |
Acuity Sustainability Consulting Limited |
Environmental Team Leader |
Jacky Leung |
2698-6833 |
ANewR Consulting Limited |
Independent Environmental Checker |
James Choi |
2618-2831 |
1.3. Summary of Construction Works
1.3.1. Details of the major construction works undertaken in this reporting quarter are shown in Table 1.2. The construction programme is presented in Appendix A.
Table 1.2 Summary of Construction Works Undertaken in the Reporting Quarter
Construction activities carried in the reporting month |
|
Wan Po Road and TKO Area 137 |
· Remains work for Chamber · Road Reinstatement |
TKO Promenade (Stage 1 Landfill) & Po Yap Road Roundabout |
· Remains work for Chamber · Road Reinstatement |
HK Velodrome |
· Remains work for Chamber · Road Reinstatement |
Po Lam Road South / Ling Hong Road |
· Remains work for Chamber · Road Reinstatement |
Tsui Lam Road / Abandoned Road |
· Remains work for Chamber · Road Reinstatement |
1.4. Summary of Construction Works
1.4.1. A summary of the valid permits, licences, and /or notifications on environmental protection for this Project is presented in Table 1.3.
Table 1.3 Summary of the Status of Valid Environmental Licence, Notification, Permit and Documentations
Valid Period |
Status |
Remark |
||
From |
To |
|||
Variation of Environmental Permit |
||||
EP no.: EP-503/2015/A |
-- |
-- |
Valid |
N/A |
Notification of Construction Works under the Air Pollution Control (Construction Dust) Regulation |
||||
423775 |
-- |
-- |
Valid |
N/A |
Chemical Waste Producer Registration |
||||
5213-839-P3287-01 |
-- |
-- |
Valid |
N/A |
Billing Account for Disposal of Construction Waste |
||||
A/C no.: 7029491 |
-- |
-- |
Valid |
N/A |
Water Discharge Licence |
||||
WT00032336-2018 |
10 Dec 2018 |
31 Dec 2023 |
Valid |
Expired in the reporting period. New Water Discharge Licence was under application |
Construction Noise Permit (CNP) |
||||
-- |
-- |
-- |
-- |
-- |
1.4.2. The status for all environmental aspects is presented Table 1.4.
Table 1.4 Summary of Status for Key Environmental Aspects under the EM&A Manual
The baseline noise monitoring result has been reported in Baseline Monitoring Report and submitted to EPD under VEP Condition 3.4 |
|
On-going |
|
Water |
|
Impact Monitoring of Disinfection Procedure |
On-going |
On-going |
|
1.4.3. Other than the EM&A works by ET, regular environmental management meetings were conducted in order to enhance environmental awareness and closely monitor the environmental performance of the contractors.
1.4.4. The EM&A programme has been
implemented in accordance with the recommendations presented in the approved
EIA Report and the EM&A Manual. A summary of implementation status of the
environmental mitigation measures for the construction phase of the Project
during the reporting period is provided in Appendix C.
2.1. Monitoring Requirements
2.1.1. To ensure no adverse noise impact, noise monitoring is recommended to be carried out within 300m radius from the nearby sensitive receivers (NSRs) during construction phase. Referring to the EM&A Manual Section 4.1.2, the impact noise monitoring should be carried out at all designated monitoring stations when there are project-related construction activities undertaken within a radius of 300m from the monitoring stations.
2.2. Monitoring Parameter
2.2.1. Impact noise monitoring was conducted weekly in the reporting quarter between 0700-1900 on normal weekdays. Construction noise level was measured in terms of the A-weighted equivalent continuous sound pressure level (LAeq). Leq 30min was used as the monitoring parameter for the time period between 0700 and 1900 on normal weekdays. Table 2.1 summarizes the monitoring parameters, frequency, and duration of the impact noise monitoring.
Table 2.1 Noise Monitoring Parameters, Time, Frequency and Duration
Time |
Frequency |
Duration |
Parameters |
Daytime 0700 – 1900 |
Once per week |
Continuously in Leq 5min/Leq 30min (average of 6 consecutive Leq 5min) |
Leq, L10 & L90
|
2.2.2. The monitoring methodology and QA/QC procedure could be referring to Section 2.4 of the Monthly EM&A Report.
2.3. Monitoring Location
2.3.1. According to the environmental findings detailed in the EIA report and Baseline Monitoring Report, the designated locations for the construction noise monitoring are listed in Table 2.2 and shown in Figure 2.1 – 2.3.
Table 2.2 Designated Nosie Monitoring Station
NSR ID |
Noise Sensitive Receivers |
Monitoring Location |
Position |
NSR4 |
Creative Secondary School |
Roof Floor |
1m from Façade |
NSR24 |
PLK Laws Foundation College |
Pedestrian Road on Ground Floor |
Free-Field |
NSR31 |
School of Continuing and Professional Studies - CUHK |
Roof Floor |
1m from Façade |

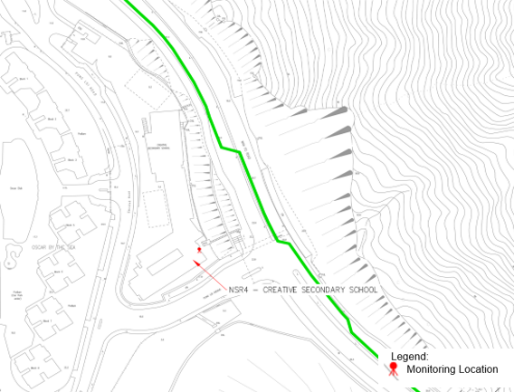

Figure 2.1 NSR4 Creative Secondary School |

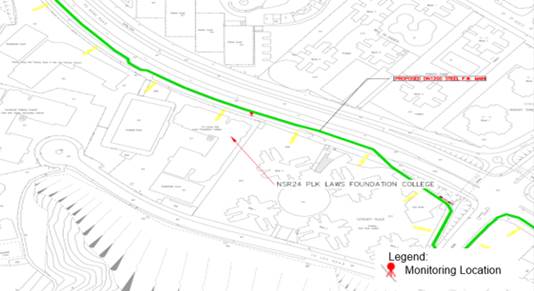

Figure 2.2 NSR24 PLK Laws Foundation College |

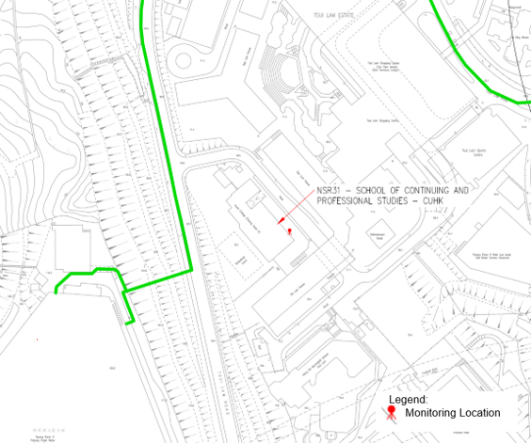

Figure 2.3 NSR31 School of Continuing and Professional Studies - CUHK |
2.4. Action and Limit Level
2.4.1. The Action/Limit Levels are in line with the criteria of Practice Note for Professional Persons (ProPECC PN 2/93) “Noise from Construction Activities – Non-statutory Controls” and Technical Memorandum on Environmental Impact Assessment Process issued by HKSAR Environmental Protection Department [“EPD”] under the Environmental Impact Assessment Ordinance, Cap 499, S.16 are presented in Table 2.3.
Table 2.3 Action and Limit Level for Construction Noise Monitoring
Time Period |
Action Level |
Limit Level |
0700 – 1900 on normal weekdays |
When one documented complaint is received from any one of the noise sensitive receivers |
· 70 dB(A) for school and · 65 dB(A) during examination period |
Notes: (a) Limits specified in the GW-TM and IND-TM for construction and operation noise, respectively. |
2.5. Monitoring Results and Observation
2.5.1. 15 times of noise impact monitoring were conducted as schedule in the reporting quarter at NSR4 Creative Secondary School since projected-related construction activities were undertaken within a radius of 300m from the monitoring location.
2.5.2. No construction works were conducted within 300m radius of NSR24 and NSR31. Thus, no construction noise monitoring was carried out at NSR24 and NSR31 in the reporting quarter.
2.5.3. The Graphical presentation of the construction noise monitoring results was shown in Figure 2.4.
Remark: The mock exam was held from 8 January 2024 to 19 January 2024, the limit level during the period would be 65dB(A).

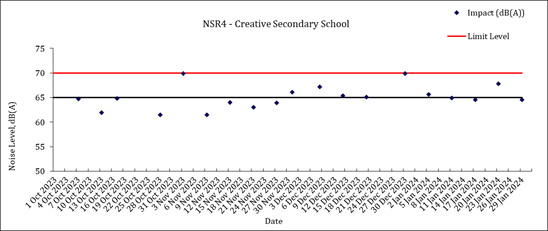

Figure 2.4 Graphical presentation of the construction noise monitoring at NSR4
2.5.4. No action or limit level exceedance of construction noise monitoring was recorded in the reporting quarter. Summary of exceedance could be referring to Appendix D.
2.5.5. If non-compliance occurred, actions as stated in Appendix F will be undertaken.
2.5.6.
The major
noise sources identified at the designated noise monitoring station were
vehicle movement near the Creative Secondary School.
3.1. Mitigation measure on waste management have been implemented in accordance with the requirements of the EM&A Manual. Suitable C&D materials were reused on-site, while the remaining C&D materials and non-inert wastes were disposed at the public filling reception facilities and the landfills respectively. The quantities disposed in the reporting quarter could be referring to Appendix G.
4. Summary of Exceedance, Complaints, Notification of Summons and Prosecutions
4.1. All construction noise monitoring was conducted as schedule in the reporting quarter. No Action or Limit Level exceedance was recorded in the reporting quarter.
4.2. Landfill gas monitoring was carried out by the Registered Safety Officer of the Contractor at the excavation locations and within the consultation zones. No Action or Limit Level exceedance was recorded in the reporting quarter. Summary of Exceedance could be referring to Appendix D.
4.3. One (1) environmental complaint was received in the reporting quarter. No notification of summons and prosecution was received in the reporting quarter.
5.1. Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. Three joint site inspections with IEC were carried out on 22 November 2023, 20 December 2023 and 18 January 2024.
5.2. Minor deficiencies were observed during weekly site inspection. Key observations during the site inspections are summarized in Table 5.1 – 5.3.
Table 5.1 Site Observations (November 2023)
Date |
Environmental Observations |
Follow-up Status |
7 November 2023 |
No major environmental deficiency was observed during site inspection. |
N/A |
13 November 2023 |
The housekeeping should be enhanced. General refuse should be cleaned and stored properly. |
General refuse was cleaned |
22 November 2023 |
1. Chemical container should be stored on drip tray to prevent leakage. 2. Missing NRMM(s) label was observed. |
1. Chemical container was removed. 2. One generator was removed. NRMM(s) label was added. |
30 November 2023 |
The housekeeping in the construction site should be enhanced. (Pit D) |
General refuse was cleaned. |
Table 5.2 Site Observations (December 2023)
Date |
Environmental Observations |
Follow-up Status |
7 December 2023 |
Tree protection zone should be maintain properly. (Pit O) |
The fencing is provided |
15 December 2023 |
Stagnant water was observed at Creative School. |
Stagnant water is cleared |
20 December 2023 |
Rock break head should be placed on tarpaulin sheet. (Shek Kok Road) |
Rock break head is removed. |
28 December 2023 |
No major environmental deficiency was observed during site inspection. |
N.A. |
Table 5.3 Site Observations (January 2024)
Date |
Environmental Observations |
Follow-up Status |
04 January 2024 |
No major environmental deficiency was observed during site inspection. |
N.A. |
12 January 2024 |
No major environmental deficiency was observed during site inspection. |
N.A. |
18 January 2024 |
1. Tree fencing/ tree protection zone should be maintained properly (Pit N & Pit O) 2. Construction site should be watering regularly in dry season. (Pit N & Pit O) |
1. Tree fencing / tree protection zone properly maintained. 2. Watering applied regularly. |
26 January 2024 |
No major environmental deficiency was observed during site inspection. |
N.A. |
31 January 2024 |
1. General refuse should be cleared regularly. (Pit M) 2. Chemical should be stored on drip tray. (Pit M) |
1. General refuse cleared. (Pit M) 2. Chemical removed. (Pit M) |
5.3. According to the EIA Study Report, Environmental Permit, contract documents and EM&A Manual, the mitigation measures detailed in the documents should be implemented as much as practical. An updated Implementation Status of Environmental Mitigation Measures (EMIS) is provided in Appendix C.
6.1. Monitoring Requirements
6.1.1. In accordance with Section 11 of the EM&A Manual, monitoring of landfill gas is required for construction works within the 250m Consultation Zone. Part of the desalination plant and the indicative area of natural slope mitigation works fall within the SENT Landfill Extension Consultation Zone; and part of the 1,200 mm diameter freshwater mains along Wan Po Road falls within the SENT Landfill and SENT Landfill Extension Consultation Zones, TKO Stage II/III Restored Landfill and TKO Stage I Restored Landfill Consultation Zones.
6.2.1. Monitoring of oxygen, methane, carbon dioxide and barometric pressure was performed for excavations at 1m depth or more within the Consultation Zone.
6.2.2. During construction of works within the consultation zones, excavations of 1m depth or more was monitored:
· At the ground surface before excavation commences;
· Immediately before any worker enters the excavation;
· At the beginning of each working day for the entire period when the excavation remains open; and
· Periodically through the working day whilst workers are in the excavation.
6.2.3. For excavations between 300mm and 1m deep, measurements should be carried out:
· Directly after the excavation has been completed; and
· Periodically whilst the excavation remains open.
6.3. Monitoring Parameter
6.3.1. Landfill Gas monitoring was carried out to identify any migration between the landfill and the Project and to ensure the safety of the construction, operation and maintenance personnel working on-site, visitors and any other person within the Project area.
6.3.2. The following parameters were monitored:
· Oxygen;
· Carbon Dioxide;
· Barometric Pressure
· Methane;
6.3.3. The monitoring methodology and equipment could be referring to Section 4.5 of the Monthly Report.
6.4. Action and Limit Level
6.4.1. Action and Limit Level for landfill gas monitoring are presented in Table 6.1.
Table 6.1 Action and Limit Level for Landfill Gas Monitoring
Parameters |
Action Level |
Limit Level |
Oxygen (O2) |
<19% O2 |
<19% O2 |
Methane (CH4) |
>10% LEL |
>20% LEL |
Carbon Dioxide (CO2) |
>0.5% CO2 |
>1.5% CO2 |
6.5. Monitoring Result
6.5.1. In the reporting quarter, landfill gas monitoring was carried out by the Registered Safety Officer of the Contractor at the excavation locations for 309 times. No action or limit level exceedance was recorded in the reporting quarter. The landfill gas monitoring results could be referring to Appendix J of the Monthly EM&A Report.
7. Conclusion and Recommendations
7.1. This is the 22nd quarterly Environmental Monitoring and Audit (EM&A) Summary Report prepared by ASCL. This report presents the EM&A works carried out during the period of 1 November 2023 to 31 January 2024 in accordance with the EM&A Manual and the requirement under EP-503/2015/A.
7.2. 15 times of noise impact monitoring were conducted in the reporting quarter at NSR4 Creative Secondary School since projected-related construction activities were undertaken within a radius of 300m from the monitoring location.
7.3. No Action or Limit Level exceedance of construction noise was recorded during the reporting quarter.
7.4. No landfill gas monitoring exceedance was recorded in the reporting quarter.
7.5. Weekly environmental site inspection was conducted during the reporting quarter. Minor deficiencies were observed during site inspection and were rectified. The environmental performance of the Project was therefore considered satisfactory.
7.6. According to the environmental site inspections performed in the reporting quarter, the Contractor is reminded to pay attention on proper storage of chemical and maintaining site tidiness. The Contractor is also reminded to consider the treatment of wastewater from the construction site area.
7.7. One (1) environmental complaint was received in the reporting quarter, which concerning suspected illegal discharge of wastewater from the construction site Pit C. The contractor reminded to follow the discharge license (license no. WT0032336-2018) issued by Environmental Protection Department under Water Control Ordinance. The muddy water should be treated before discharge and the water quality should fulfil the requirements of the discharge license.
7.8. No notification of summons and prosecution was received in the reporting quarter.
7.9. The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.
7.10. Statistics on complaints and regulatory compliance are summarized in Appendix E.
